Skip to main content

Vendor deposits

A vendor deposit is money you pay a supplier up front, before the goods ship — a prepayment. Many suppliers, especially overseas manufacturers, require one: for example, "30% on order, 70% before we ship." That up-front payment is often requested on a proforma invoice — a preliminary bill the supplier sends before the real invoice, used to request the deposit and confirm the order.

SKU.io tracks these prepayments against the purchase order (PO) they belong to, so the cash you've committed is always tied to the order it's paying for. Everything lives on the PO's Deposits tab, which keeps two layers deliberately separate:

  • Expected Deposit Milestones — the plan: when and how much you'll owe.
  • Vendor Deposit Documents — the actual deposit records you pay and track.

This guide covers turning a milestone into a real deposit, recording an ad-hoc deposit or proforma invoice, and reading each layer's statuses.

A deposit points the opposite way to a vendor credit

A deposit is cash you commit to the supplier ahead of delivery. A vendor credit is money the supplier owes back to you — for returns, over-bills, or refunds. If you're chasing money coming the other way, see Vendor credits instead.

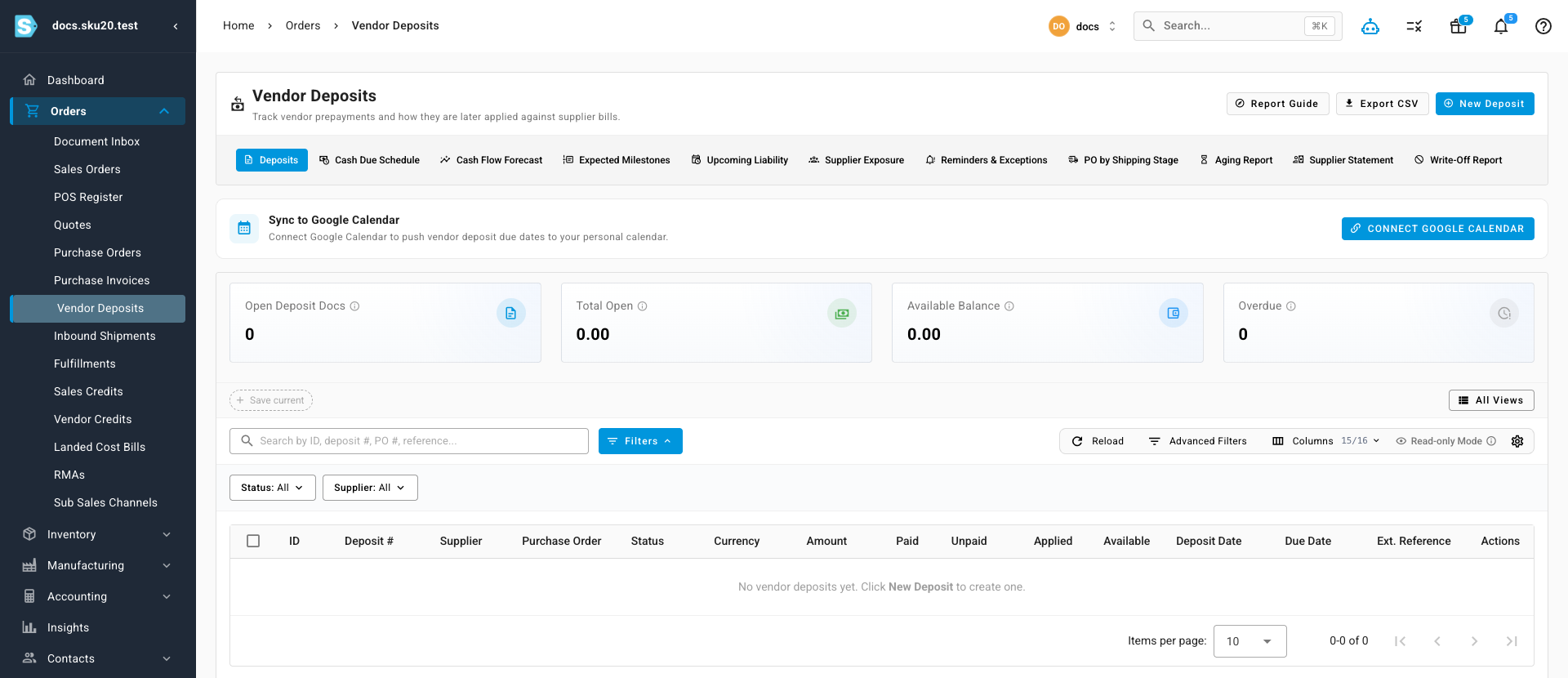

The Vendor Deposits area — prepayment tracking with summary tiles, reporting tabs (Cash Due Schedule, Aging, Supplier Statement), and the New Deposit action

Before you begin​

  • Open the purchase order you want to work with from Orders → Purchase Orders. The examples below use PO-DOCS-0001 (supplier Acme Supplies, destination Main Warehouse).
  • Vendor deposits have their own tab on the PO detail page: Deposits. The tab badge shows how many are linked.
  • Creating a deposit from a schedule milestone requires the Update purchase orders permission — without it, the Create Deposit button doesn't appear.

Milestones vs. deposit documents​

Open the PO and select the Deposits tab. It shows two tables that are two layers of the same idea — and it's important not to confuse them:

LayerWhat it meansIs it a financial record?
Expected Deposit MilestonesPlanning rows worked out from the PO's payment-term schedule. Each milestone has a trigger event, a basis date, a due date, and an amount (a percentage of the PO total or a fixed amount).No — a milestone is a forecast of a deposit you'll owe.
Vendor Deposit DocumentsThe actual deposit records, each with its own status, amount, paid, applied, and available balance. Created from a milestone or entered by hand.Yes — this is the real prepayment you pay and track.

A few terms these tables use:

  • Basis date — the date the milestone counts from (for example, the PO approval date). The due date is worked out from it, such as "10 days after approval."
  • Applied — how much of a paid deposit has been used up against the supplier's final invoice. A deposit starts fully Available; as the real bill arrives, the deposit is applied against it and the available balance drops.

Milestones become real deposits over time: once a milestone's trigger event happens, it's marked Ready to create, and you turn it into a vendor deposit document.

A worked deposit schedule​

Say PO-DOCS-0001 totals $10,000, and Acme's payment terms are 30% on approval, 70% on first shipment. SKU.io lays that out as two Expected Deposit Milestones:

MilestoneTriggerAmount (% of PO)Amount ($)Status before trigger
Deposit 1PO Approved30%$3,000Expected
Deposit 2PO First Shipment70%$7,000Expected

Here's how the schedule plays out:

  1. You approve the PO. The PO Approved trigger fires. Deposit 1 flips from Expected to Ready to create. You create it, pay Acme $3,000, and that deposit's Available balance sits at $3,000 until the final invoice arrives. Deposit 2 is still Expected — its trigger hasn't happened.
  2. Acme records the first shipment. The PO First Shipment trigger fires. Deposit 2 flips to Ready to create. You create it and pay the remaining $7,000.
  3. Total prepaid: $3,000 + $7,000 = $10,000 — the full PO value, committed across the two milestones exactly as the payment terms describe.

Later, when Acme's real invoice arrives for the goods, you apply these deposits against it so you're not billed twice for money you've already paid. See Invoicing and the 3-way match for how the final invoice is reconciled.

Percentage or fixed — your choice

A milestone amount can be a percentage of the PO total (30%) or a fixed amount (a flat $3,000). Percentages recalculate if the PO total changes; fixed amounts don't.

Milestone statuses​

Each milestone row carries a status chip (hover it for the full explanation):

StatusMeaning
ExpectedThe payment term says this deposit should exist later, but the triggering PO event hasn't happened yet.
Ready to createThe triggering event has happened. The next step is to create the actual deposit document.
CreatedA deposit document is already linked to this milestone.
Out of syncA linked deposit exists, but the payment-term schedule no longer matches it exactly and needs review.

What triggers a milestone​

A milestone's Trigger column names the PO lifecycle event that makes it ready. SKU.io fires that event exactly once, on the boundary transition — not every time something is recalculated:

TriggerFires when the PO…
PO Approvedis approved (moves from Draft to Open).
PO First Shipmentrecords its first shipment (from unshipped/planned to any shipped).
PO Fully Shippedbecomes fully shipped.
PO First Receiptrecords its first receipt (from unreceived to partially or fully received).
PO Fully Receivedbecomes fully received.
Manual / Logistics Tracking Dateis triggered by hand or by a logistics tracking date rather than a status change.

SKU.io also keeps draft deposits roughly in step with the schedule for you: when a PO's payment term or PO date changes, it re-works the draft deposits to match. For the status transitions that drive these triggers, see How purchase order status works.

Changing PO dates can move your milestones

Editing the PO's dates can shift the schedule and move its milestones (a later basis date pushes the due dates out). When a change would affect deposit milestones, SKU.io warns you before you save so you can preview the impact — read that preview before confirming.

Create a deposit from a ready milestone​

  1. On the Deposits tab, find a milestone whose status is Ready to create.
  2. Click Create Deposit on that row.

SKU.io turns the milestone into a vendor deposit document (in Draft), pre-filled from the milestone's amount and due date, and links it back to the milestone.

What you'll see: the milestone's status changes to Created, and the new draft deposit appears in the Vendor Deposit Documents table below.

No duplicates

A milestone that already has a linked deposit, or that isn't ready yet, can't be created again — the action returns an explanatory message instead of making a second deposit.

Record an ad-hoc deposit or proforma invoice​

When a deposit isn't tied to a scheduled milestone — for example, the supplier sends a proforma invoice out of the blue and asks for payment — record it directly:

  1. On the Deposits tab, click Record PI / Add Deposit. (You can also start from the PO's More menu (⋮) → Record Proforma Invoice / Request Payment, which opens the same drawer on the Deposits tab.)
  2. In the Record Proforma Invoice / Request Payment drawer, the Supplier, purchase order, total, and currency are pre-filled from the PO, along with the remaining deposit capacity.
  3. Enter the deposit value. Toggle between Amount and Deposit % of PO to enter it either way.
  4. Attach the supplier's proforma invoice if you have one, then click Save as Draft.

What you'll see: a new vendor deposit document appears in the Vendor Deposit Documents table in Draft. It then follows its own approval workflow before it can be paid and applied.

Deposits are capped at the PO total​

PO-linked deposits can't exceed the purchase order's total. Continuing the $10,000 example: once your deposits already linked to the PO add up to $10,000, you've used all the capacity.

You can't over-commit against a PO

Once linked deposits cover the PO total, both Create Deposit and Record PI / Add Deposit are disabled, and their tooltip explains that additional PO-linked deposits are blocked because linked deposits already cover the purchase order total. Cancelled, void, refunded, and written-off amounts free that capacity back up.

Third-party deposits: freight, duty, and inspection prepayments​

Not every prepayment on an order goes to the order's own supplier. On a DDP shipment, for example, you often pay the freight forwarder directly — against their proforma invoice, before any real invoice exists. That money economically belongs to this purchase order, but the forwarder is a different supplier entirely.

Record it as a vendor deposit to the service provider (the forwarder, customs broker, or inspection agency), and reference the purchase order it belongs to. The deposit then appears on the PO's Deposits tab in its own Third-Party Deposits card — so the order's true cash picture includes prepaid freight and duty — without touching anything that belongs to the goods supplier:

  • Expected Deposit Milestones are unaffected. Third-party deposits never appear in, or alter, the payment-term schedule.
  • The PO's deposit capacity is unaffected. A freight prepayment doesn't consume the goods supplier's deposit cap — it can even exceed the PO total.

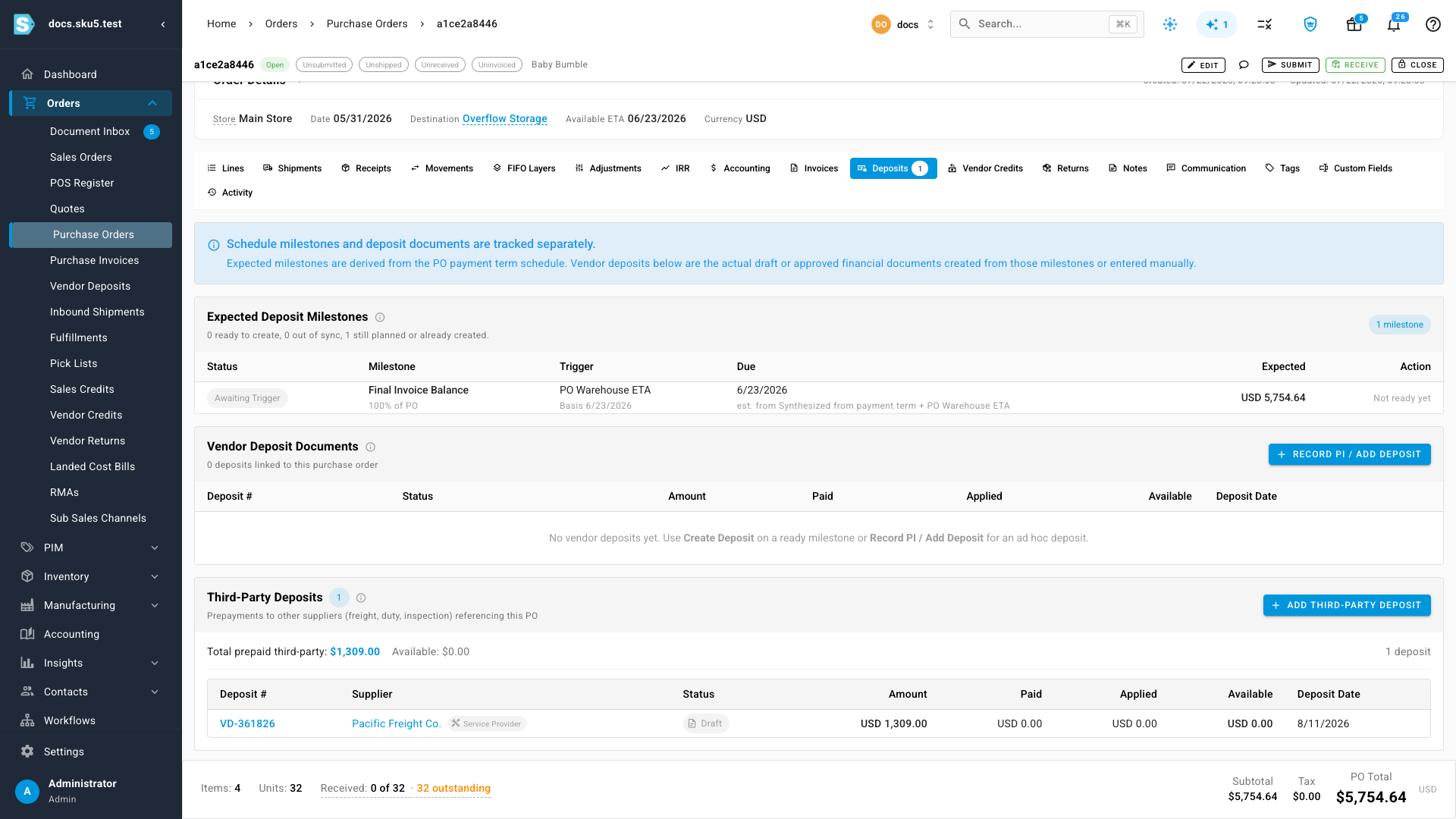

The Third-Party Deposits card on a PO's Deposits tab — prepayments to other suppliers, with their own total, sitting apart from the milestone schedule and deposit documents

To add one from the PO, click Add Third-Party Deposit on the card (or in the Deposits tab header when the card is empty). The deposit drawer opens with the reference to this PO preset — pick the service provider being paid, enter the amount, and save. You can also start from Orders → Vendor Deposits and turn on Reference another supplier's PO in the drawer.

A deposit has either a primary purchase order link (its own supplier's PO, which drives milestones) or a third-party reference — never both. Everywhere the deposit appears, the referenced order carries a 3rd party badge so the two kinds are never confused:

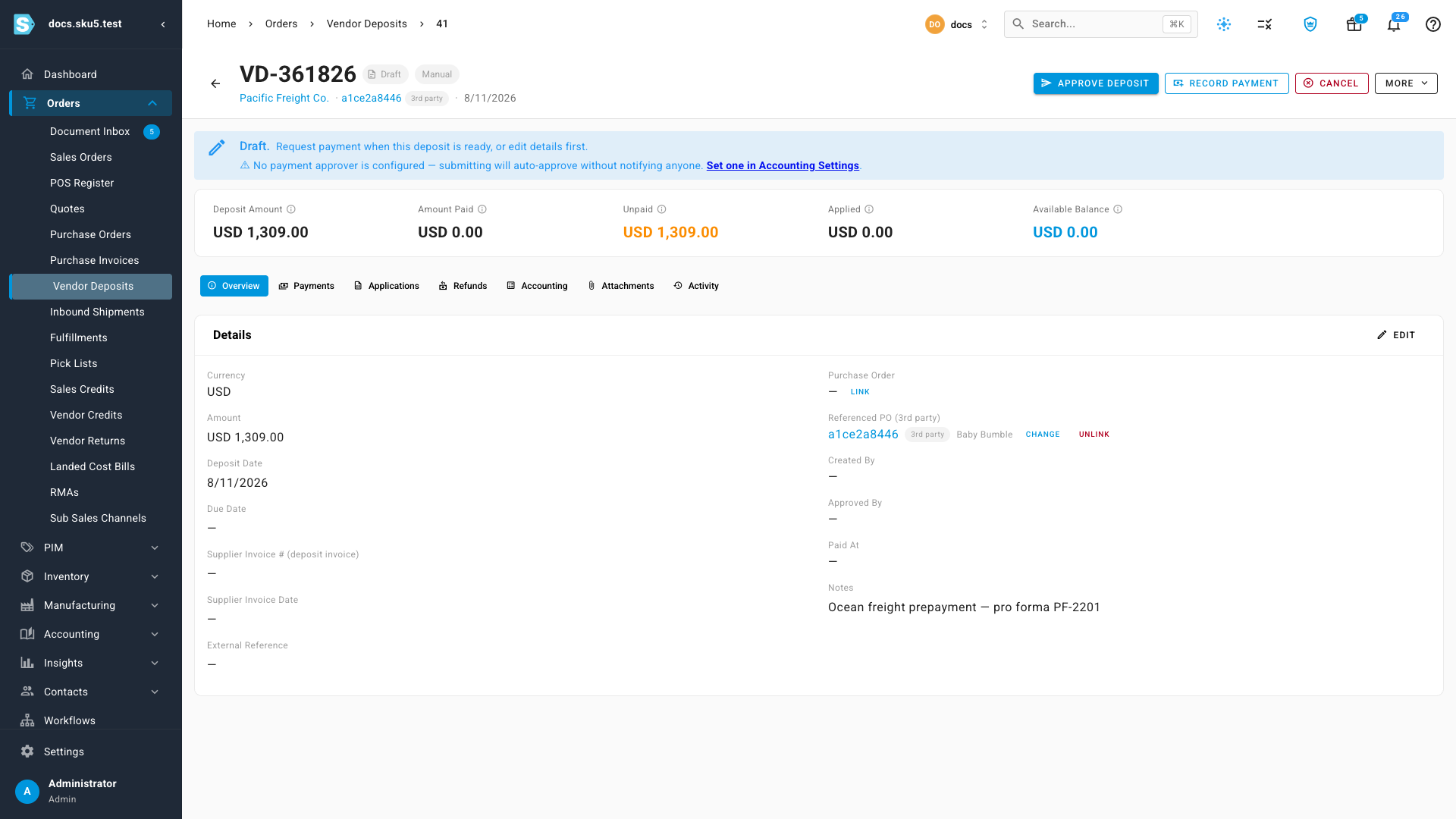

A third-party deposit's detail page — the referenced order shows with a "3rd party" badge and the name of the supplier that owns it

Settling the prepayment

When the service provider's invoice for this order arrives, apply the deposit against it as usual — deposits always settle against the deposit's own supplier's invoices. Because the deposit references the order, the matching invoice is suggested first in the apply dialog.

Deposit statuses​

A vendor deposit document moves through its own lifecycle, shown as a status chip in the Vendor Deposit Documents table:

StatusMeaning
DraftCreated but not yet submitted for approval.
Pending approvalSubmitted and awaiting sign-off.
ApprovedSigned off and ready to be paid.
Partially paidSome, but not all, of the deposit amount has been paid.
PaidThe full deposit amount has been paid to the supplier.
Partially appliedSome of the paid deposit has been used against the supplier's invoice; a balance is still Available.
Fully appliedThe whole deposit has been used up against invoices — nothing left to apply.
RefundedThe supplier returned the money.
Written offThe deposit was cleared from the books as unrecoverable.
Void / CancelledThe deposit was voided or cancelled before completing.

The table also shows each deposit's Amount, Paid, Applied, and Available balance. Click a deposit number to open its detail page.

Overdue prepayments are flagged for you

An approved vendor deposit that's overdue and still unpaid shows a warning icon on the purchase orders list — so you can spot prepayments that need attention without opening each PO.

How vendor deposits reach your accounting​

Vendor deposits keep their own accounting records, separate from the PO's own accounting entry. Those records are what your accounting integration (such as Xero or QuickBooks) mirrors. For how the PO itself posts to accounting when stock is received, see How a PO becomes inventory.

Next steps​

Last verified:
